We are excited to inform you about the construction progress of our project.

Essential Buildings:

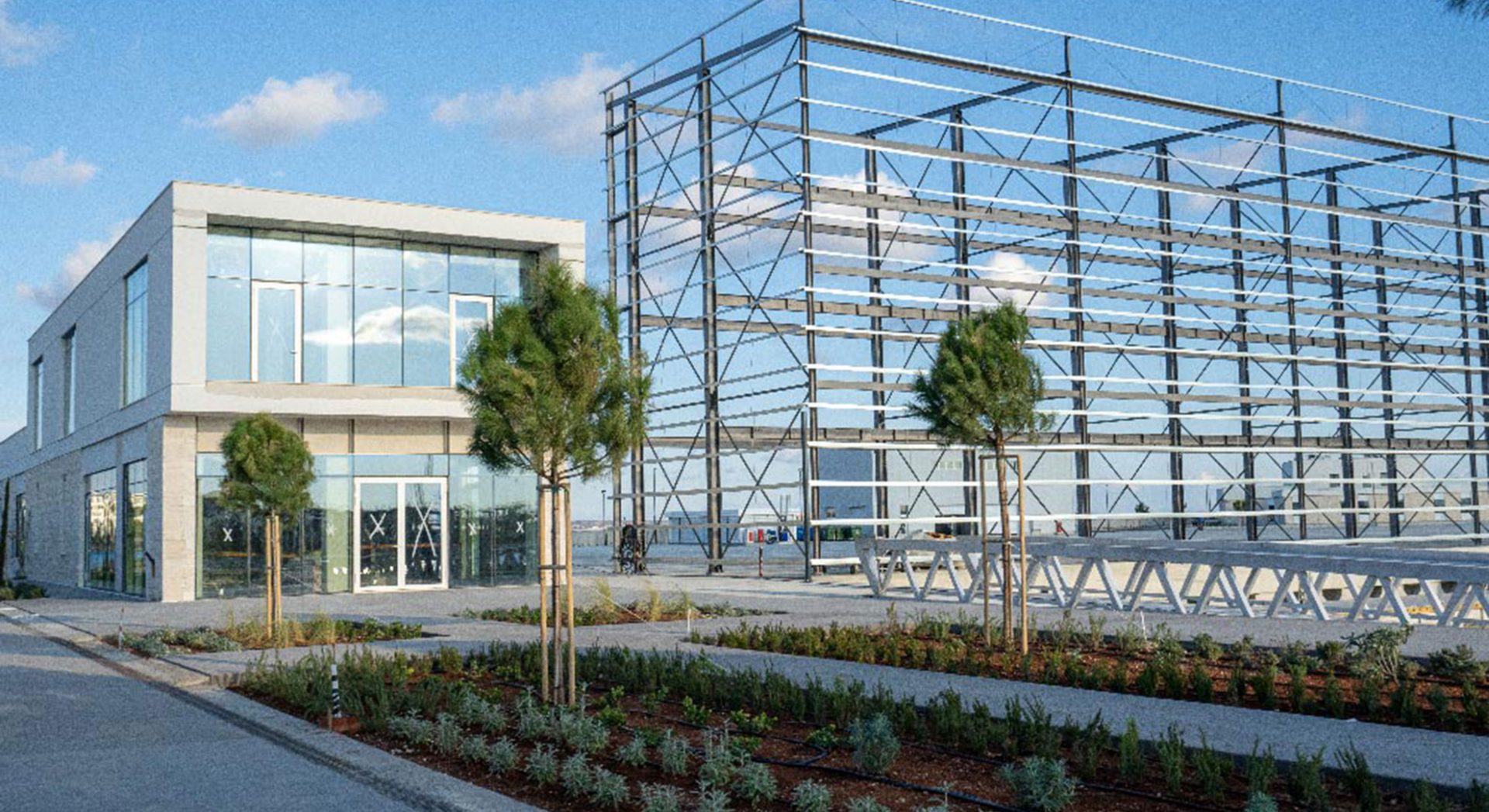

The Government building’s construction works have been finalized, while the furnishing of the building along with the installation of the telecommunication mast are also completed. At the same time the final finishes are installed in the Comfort Station, Chandlery and Administration Buildings. The erection of steelwork for the Dry Stack building has been completed.



Marine Works:

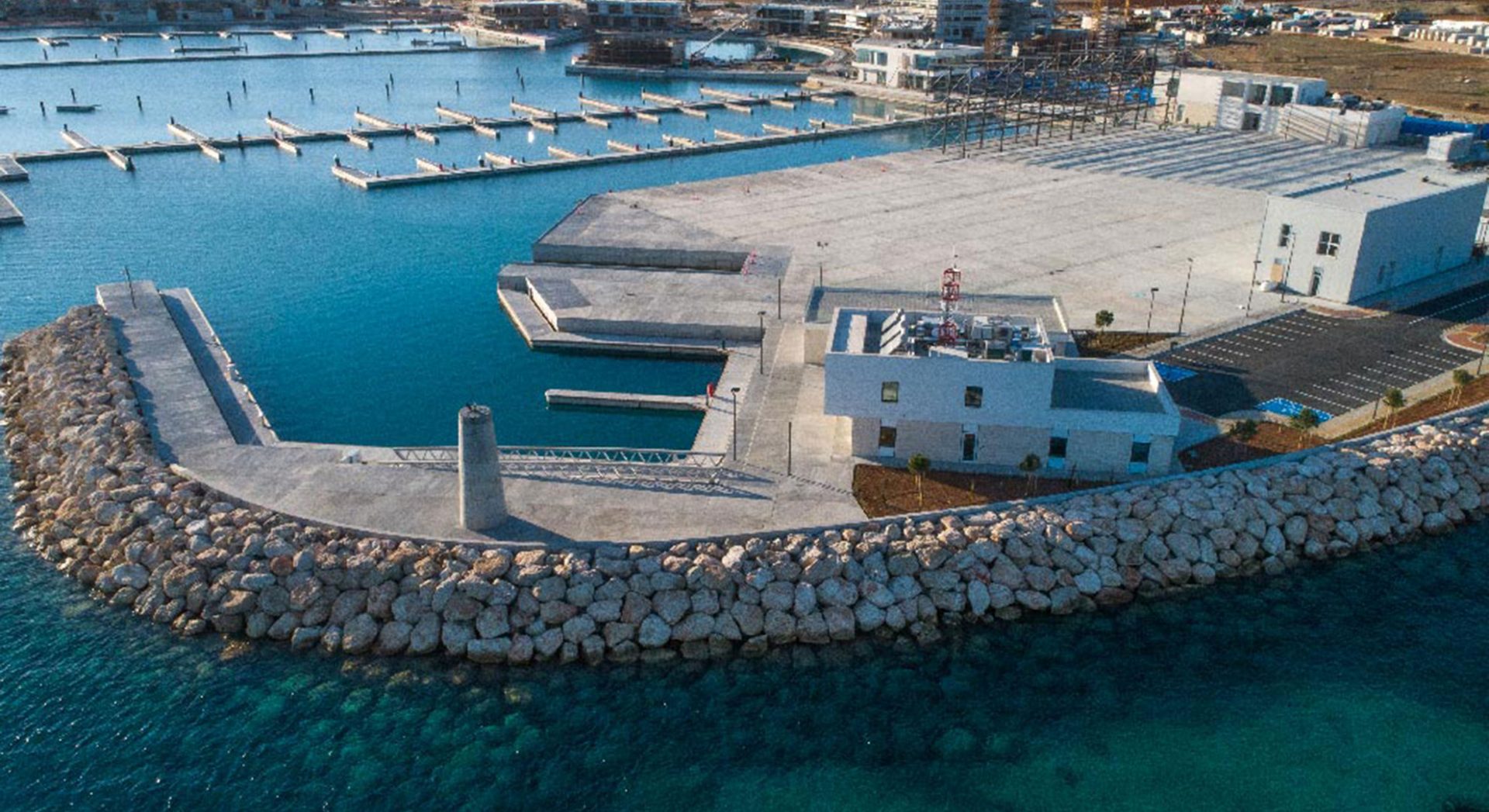

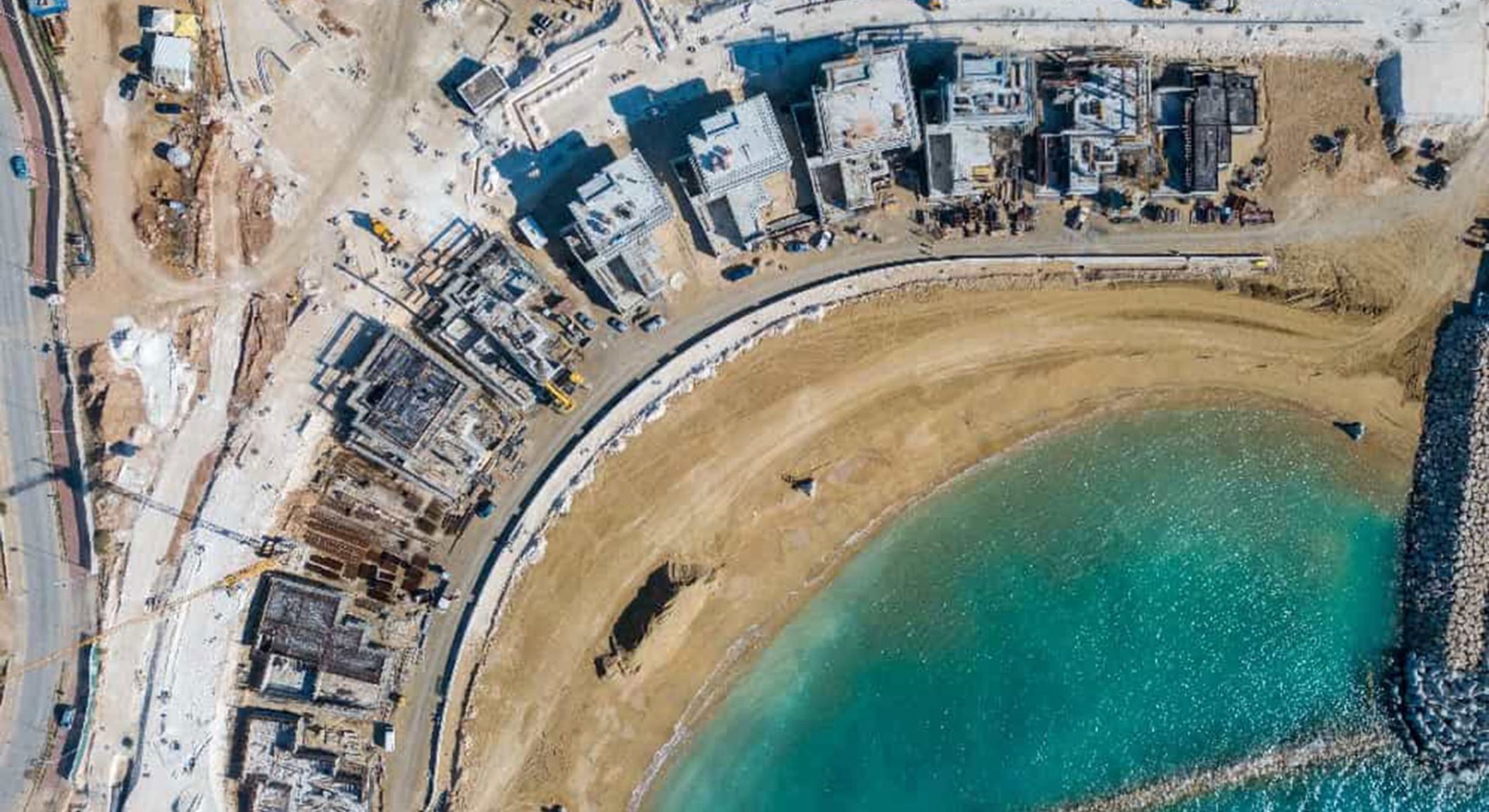

The South Breakwater is at 100% completion while the asphalt layer on the road adjacent to it was constructed on 09.11.2019. The East Revetment as well as the West detached breakwater are completed. The placement of sand at the artificial beach is at 98% completion as. The casting of the Boatyard pavement has been finalized and the installation of the fuel tanks and relevant infrastructure have also been finalized. The Floating Docks have been put in place for the following docks: Naval, Cronus, Oceanus, Apollo, Hermes, Aphrodite and Hestia and the installation of their gangways, services and pedestals is in progress.



Roadworks:

The roadworks construction is ongoing for the west side of the development and the asphalt paving of East Road is now completed. The landscape works have also commenced (hard & soft).

The removal of backfill material below the bridge is now completed and the bridge is now used for accessing the island.



Parking Garage:

The Parking Garage construction has finished. The installation of the MEP services is ongoing having an overall completion percentage of 95%. The support system for the aluminum expanded mesh has been finalized. The installation of the external stone cladding is at 70% completion.



Commercial Building A:

At the internal areas of Pyare A, the activity of plasterboard has been completed by 50%. The sanitary fittings and the screeds have been completed in the Public Toilets area. Externally, the activity of trellis fixing has commenced, the installation of the external stone cladding is at 90% completion. The MEP installation works are at 95% completion.



Commercial Buildings B & C:

At the internal areas of Commercial Buildings, the activity of plasterboard has been completed by 95%. Externally, the activity of trellis fixing has commenced, the installation of the external stone cladding is at 90% completion. The MEP installation works are at 95% completion.



Commercial Building D:

At the internal areas of Commercial Building D, the activity of plasterboard has been completed by 40%. Externally, the activity of trellis fixing has commenced, the installation of the external stone cladding is at 80% completion. The MEP installation works are at 95% completion.

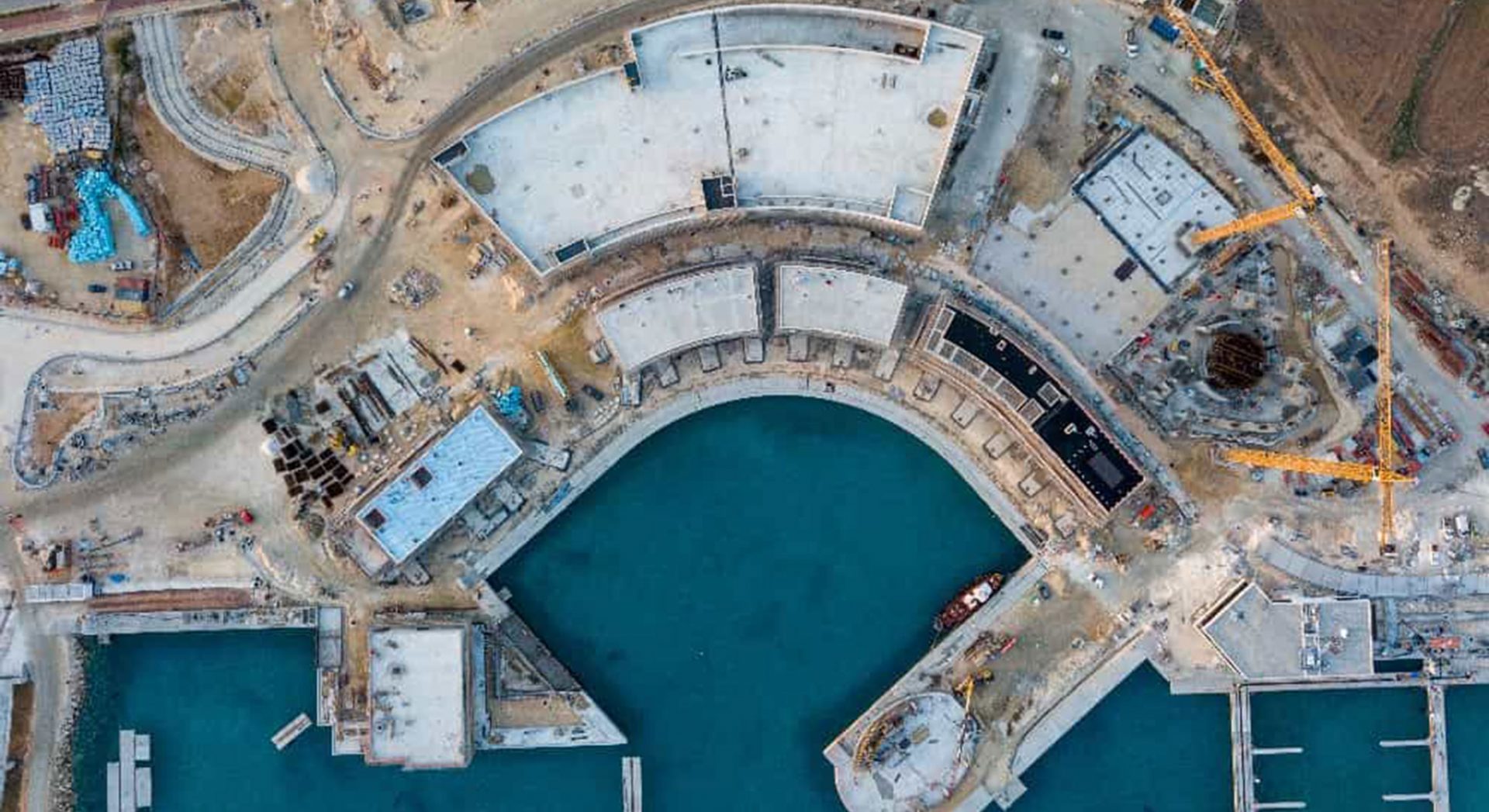

Event Centre:

The casting of the reinforced concrete walls is well progressed, reaching a completion percentage of 70%. The casting of the concrete ceiling plan is at 50% completion.



Yacht Club:

The construction of the concrete framework has been completed as well as the blockworks activities. The roof waterproofing is in progress, reaching an overall completion percentage of 90%. At the same time, the external concreting works of the yard is at 70% completion.

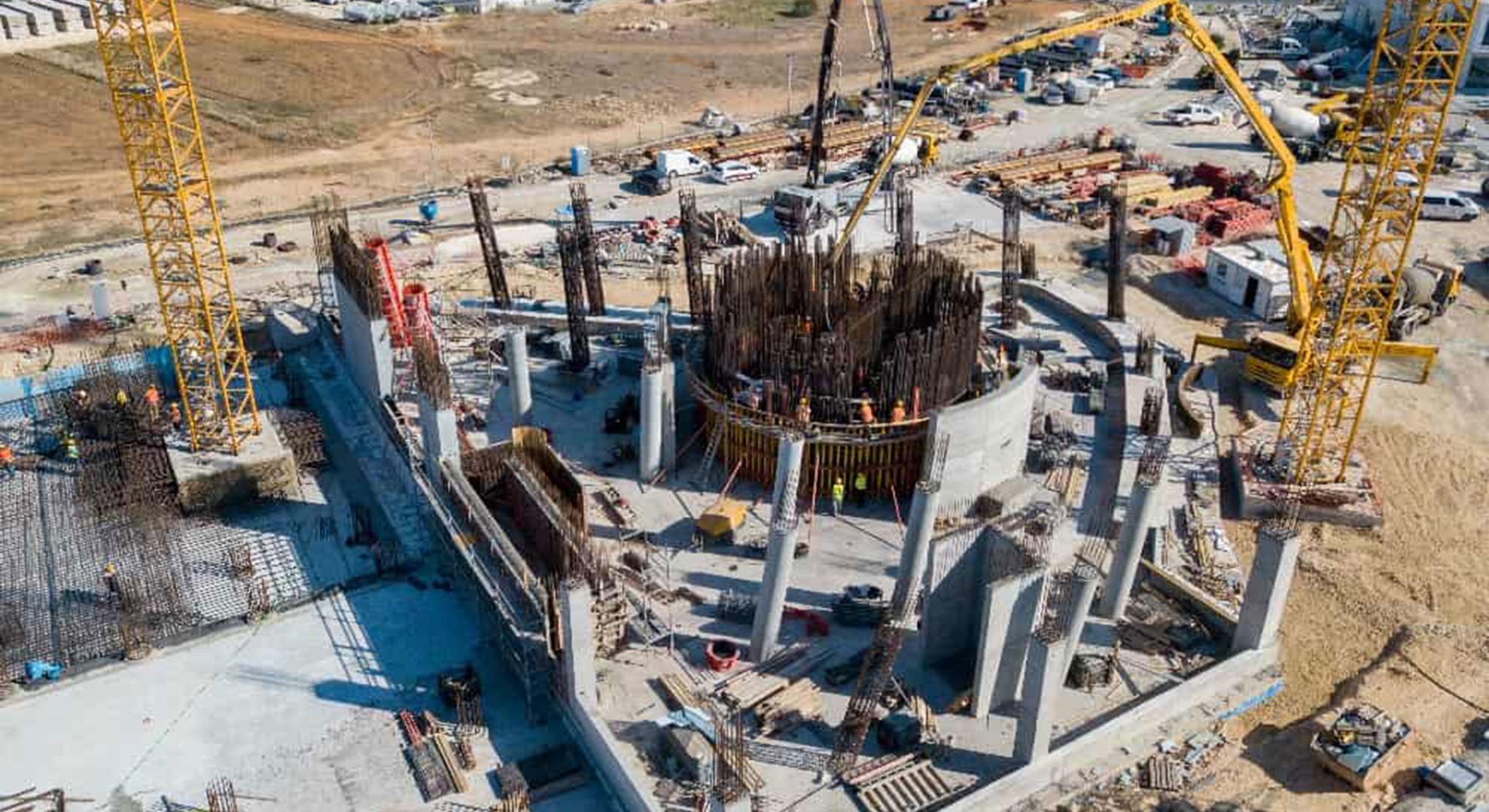

East Tower:

The reinforcement works is at the ground floor core walls have been finalized while the formwork erection progress is at 60% completion. The raft foundation of the podium structure has commenced with the first two casts being completed on 10.12.2019 and remaining 3 casts being at 50% completion.



West Tower:

The dewatering system of the West Tower has been installed.



Island Villas:

Structural concrete works are ongoing at all Villas. Blockworks and architectural finishes have commenced.



Beach Villas:

Structural concrete works are ongoing at all Villas (except Villa 3-steel yard). Blockworks and architectural finishes have commenced.



Peninsula Villas:

Building permit to be issued.

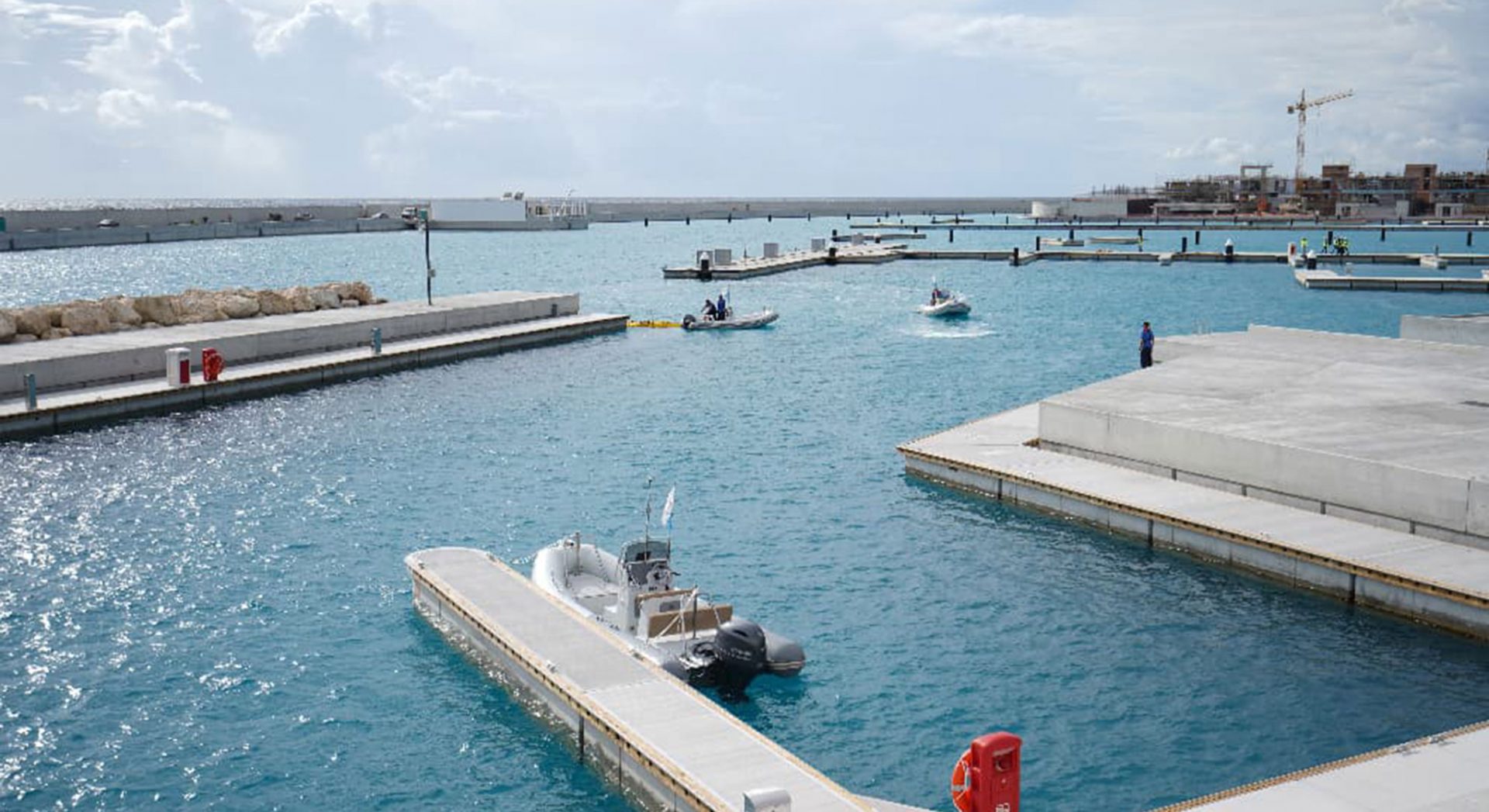

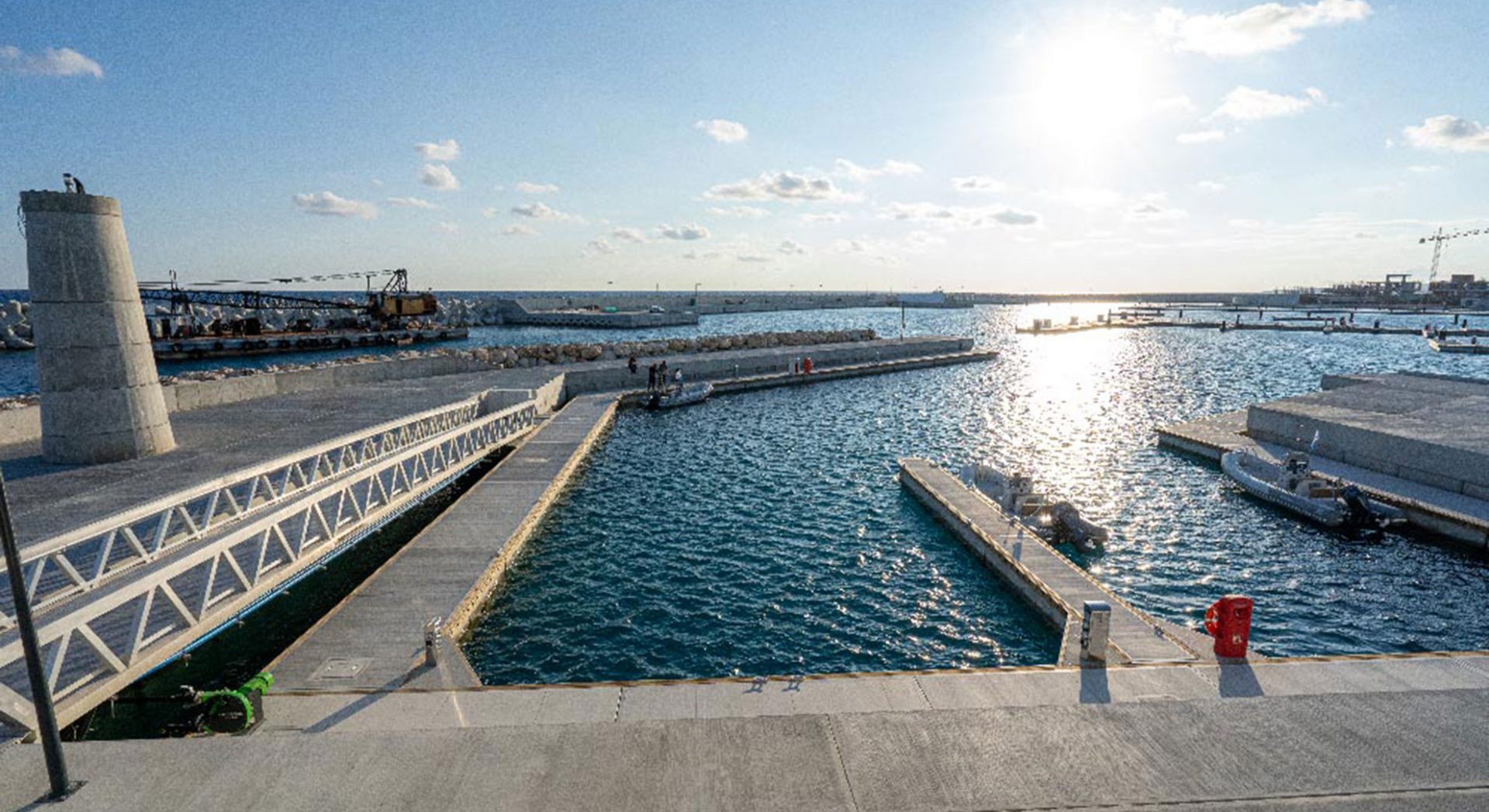

Another significant milestone has been recently achieved. Dedicated to the completion of the iconic Ayia Napa Marina, on 27 November 2019, we have proudly completed the first part of this impressive project, the unveiling of the berthing facilities and the start of pilot operation.

Take a look at the pictures and watch our latest construction progress update video below to grasp the amount of the progress which has been achieved.  The video takes you through the progress made through the whole of 2019.
